Ecommerce Website Development Project Plan: A Guide to Your Project Preparation

Guides & Advice
12 MIN READ
March 23, 2021
BLOG
Guides & Advice
Ecommerce Website Development Project Plan [+Examples]
4
(18)

Ever wondered how successful projects are born? With an elaborate ecommerce website development project plan.

Project management has five phases, and project definition & planning is probably one of the most important ones. After the discovery and initiation phase is done and your website specification document is all ready, it’s time to prepare the ecommerce website scope of work and a general project roadmap for your team to follow.

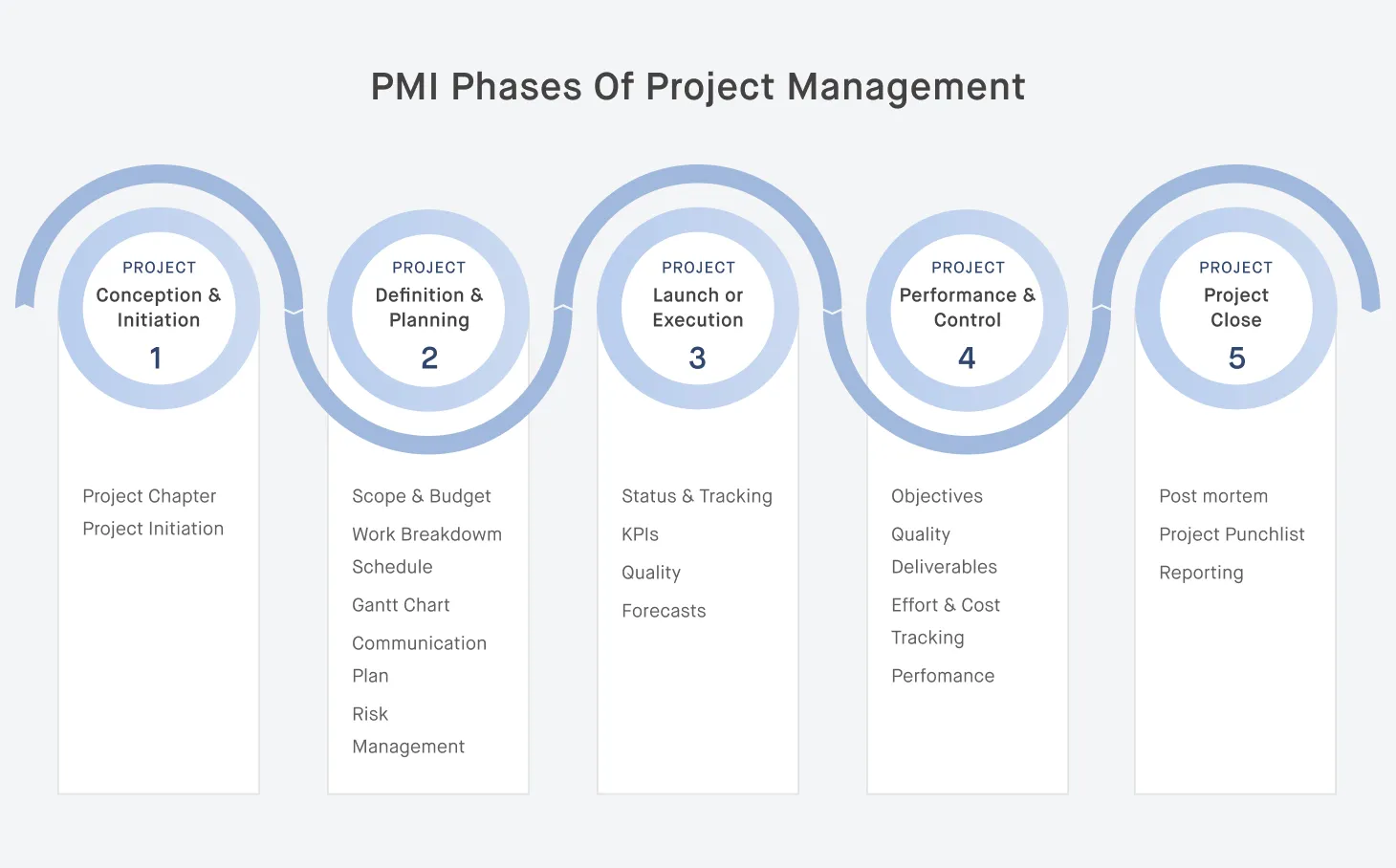

PMI phases of project management. Source: SmartSheet.

At Elogic, we know that well planned is half done, so we get very scrupulous when it comes to this second phase of project management. Having put on a planner’s hat, we develop the timeline, budget, and work breakdown structure for ecommerce websites. We even try to foresee the plans that are not in plans just yet.

Read this article on our approach to website project planning and learn how to estimate and implement a lasting ecommerce project.

Project Plan, Scope, and Roadmap: One and the Same Thing?

Terminology can be confusing. And before we get down to a planning process, it’s important to distinguish between three absolutely different project documents: project plan, project scope, and project roadmap.

Ecommerce website development project plan includes all working documentation required to fulfill a project. Divided in sections, it lists the stakeholders’ roles and names, the schedule and duration of the project, the budget allocated for each step, project risks and assumptions, change request management, and more. It basically encompasses all the other documents established for the project and should be your reference point during the execution of a project.

Ecommerce website scope of work defines the project purpose, deliverables, and major known risks and constraints. It lays out the basic information to start an ecommerce business and is less detailed than a project plan. A project scope may be a stand-alone document to start the planning phase or form a part of a project charter filled and signed at the initiation phase of project management.

Ecommerce website roadmap provides a strategic overview of the project execution, with its major milestones and the time for realization. It is usually structured as a diagram and keeps a merchant informed on the project’s progress.

If these definitions sound new for you, why not share them with your project manager? Click below to share the article on social media.

Why Project Planning Is Important

In one of it’s whitepapers, the Project Management Institute (PMI) reports that Intel has “90 percent of projects hit their release dates or went over by just a few days, and the IT department is delivering more projects per year on roughly the same budget as before”.

Intel’s case basically summarizes all the implied benefits of the planning process. Apart from creating the essential project documentation (like the one listed above), this phase is important for several reasons:

  1. A plan helps you get realistic about your budget, timeline, and capabilities and stay this way throughout the project.
  2. Your project decisions are driven by clear goals and objectives, so it’s hard to go over the project scope unless you’re about to add some relevant functionalities.
  3. It’s a way to keep your finger on the pulse of the project: to see whether the tasks are completed in order and on time to come at an expected release date.
  4. Planning allows you to assess risks and reduce their impact on your project.
  5. At the final phase of the project management, the plan serves to analyze how well you’ve achieved your goals and what else needs to be done to bring value to your business.

Ironing out the project details before you actually begin it will help you make the development process — be it replatforming, integration, or any other development service — as painless as possible.

Ecommerce Project Planning Explained Step by Step

Once we have the brief filled in and the discovery phase finished, we start planning the project. Ecommerce website development project plan involves five steps on the way to project estimation and implementation. We add a bonus step upon our clients’ request following PMI best practices. Read on!

Step #1: Write Down Ecommerce Website Scope of Work

A scope statement is the first general outline of the project that gives rise to the rest of the working documentation. It can be changed along the project but is initially created by a project manager and all involved stakeholders.

Ecommerce website scope of work typically consists of the following sections:

Project Purpose / Business Justification — a brief description of the project and reasons for its implementation.

Objectives — a breakdown of the expected outcomes of a project. It’s important to be specific at this point, so businesses are advised to take advantage of a SMART or a CLEAR model to articulate the goals. Both are acronyms and, depending on your business focus, allow you to set attainable, measurable goals that will keep your project and employees right on track.

CMART and CLEAR acronyms explained.

Deliverables — all the assets that a development team is committed to deliver throughout the project. This part includes all the project-related documentation to be delivered as well as services to be provided (e.g., website development from scratch, ecommerce replatforming, third-party integration, etc.).

Scope — a list of high-level units and tasks to be executed throughout the project. It’s basically a predecessor of a WBS to be completed in the next step of planning.

Project milestones — the important tasks and achievements that mark a certain stage of the project completion. They are predecessors of a project timeline and represent a clear sequence of events showing how the project advances.

Major known risks — external conditions that may adversely affect a project’s progress. The likelihood of each risk occurring and the severity of its risk should be estimated at this point.

Constraints — restrictions defining a project’s limits (e.g., budget, schedule, dependency on third-party software releases, etc.). These may also include the external dependencies — activities and tasks outside the team’s control — that may affect the project implementation.

Step #2: Organize Deliverables Into a WBS

A work breakdown structure (WBS) for an ecommerce website is a visual, hierarchical deconstruction of a project. It is built based on our clients’ requirements in three simple steps:

  1. articulate high-level deliverables (or use the ones identified in the project scope as explained in step #1);
  2. think about the tasks within each of the mentioned deliverables;
  3. get granular and split the tasks into even more detailed subtasks.

This way, a WBS breaks a large project down into smaller, chewable chunks of work to be done.

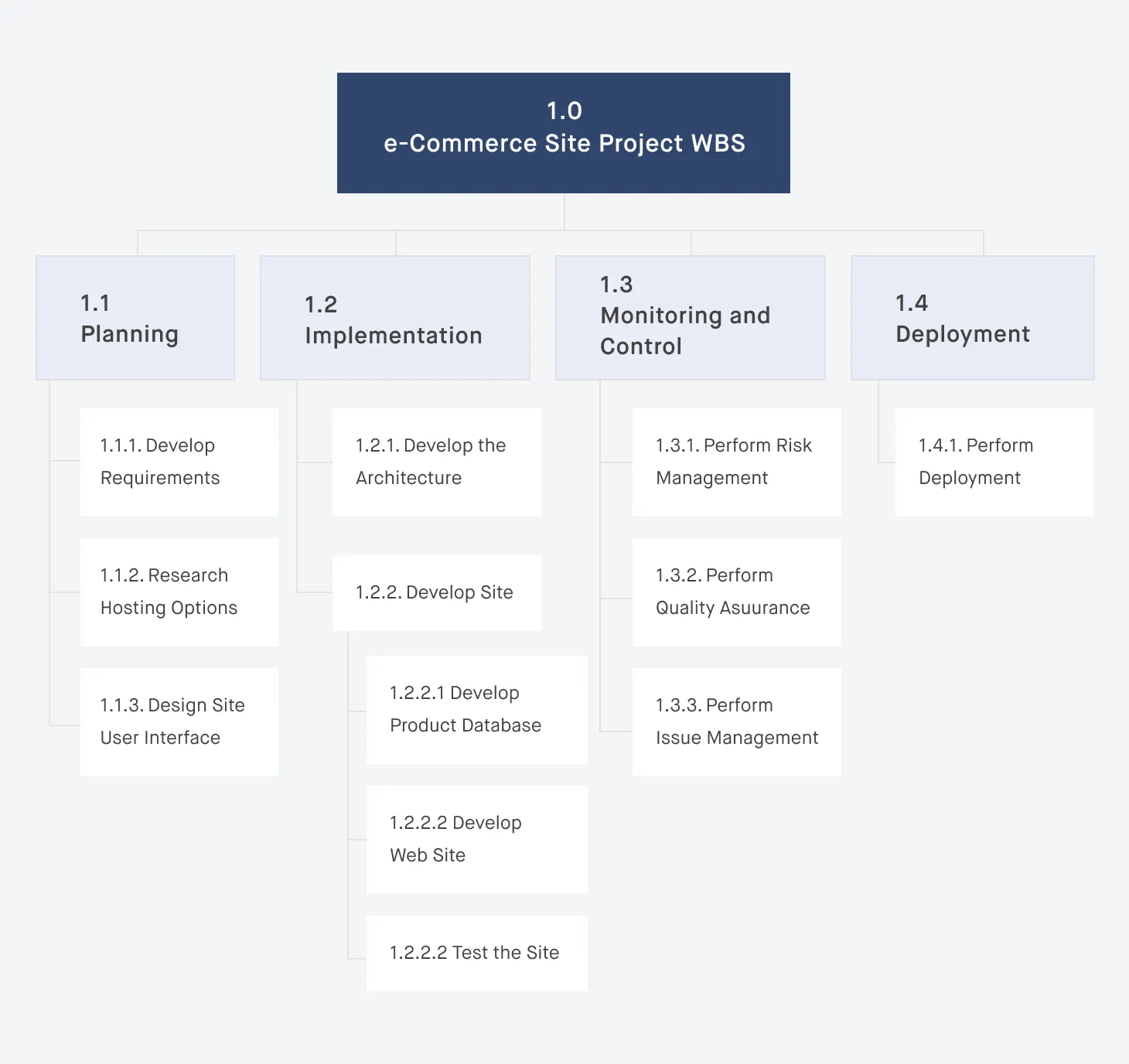

Take a look at the example of a work breakdown structure for an ecommerce website: the final deliverables stay on top of the tree diagram, while all subdivisions refer to manageable tasks to be assigned to a single person.

A deliverable-based WBS for an ecommerce website
A deliverable-based WBS for an ecommerce website. Source: PM Documents.

Why use a WBS? For starters, because it’s physically impossible for a single project manager to consider all the tasks to be done, especially on large projects. A WBS keeps the work organized and doesn’t let any tasks escape one’s attention.

A WBS also acts as an ecommerce website roadmap. It helps a team to keep up with the project deadlines and mitigate the potential risks of cost overrun and scope creep.

Step #3: Study the Dependencies

Now, as your project has been broken down into smaller pieces, you can go ahead and create an ecommerce website roadmap, a to-do list for each work package. But here’s the thing that slips the mind of many inexperienced project managers: dependencies.

Project dependencies refer to the logical relationships between the tasks in which one task or activity depends on the completion or initiation of another.

Indeed, some tasks will be completed at the same time, whilst others won’t start until another ends. A project manager should recognize the order in which the tasks specified in a WBS should be done and write them down into a dependency log.

Studying project dependencies has a number of important implications:

  • It is a way to take the responsibility off developers’ shoulders for the things they can’t control, like third-party software support or alien connectors.
  • It allows the project management team to compute the impact of changes and the “what if” scenarios leading to risk assessment.
  • It’s also a way to tap into the time estimates for each task and prepare for the next step of planning: setting the timeline of a project.
To plan project dependencies and to define the structure of the project components, you may need to turn to a solution architect. Read on this ecommerce role and learn how a Magento solution architect will strengthen your development team.
Guides & Advice
Do You Need a Magento Solution Architect to Design Your Ecommerce Store?

Step #4: Set a Project Timeline

Once your project deliverables have been mapped out and dependencies established, you can set your project timeline. At Elogic, we build and present a project timeline using a Gantt chart.

A Gantt chart puts the dependencies and resources identified in the previous steps of the planning journey in a single bar chart. It presents a visually clear view of the time you allocated to each task as well as their dependencies.

The vertical axis of the chart stands for the tasks to be completed, whereas the horizontal axis — for the time allocated. The chart also shows the start and finish date of the project, the duration of each task, and the way in which tasks group together, overlap, and link with one another. We also further subdivide the tasks into periods called sprints that end with each achieved milestone.

Gantt chart showing the tasks in each project sprint and their timeline.

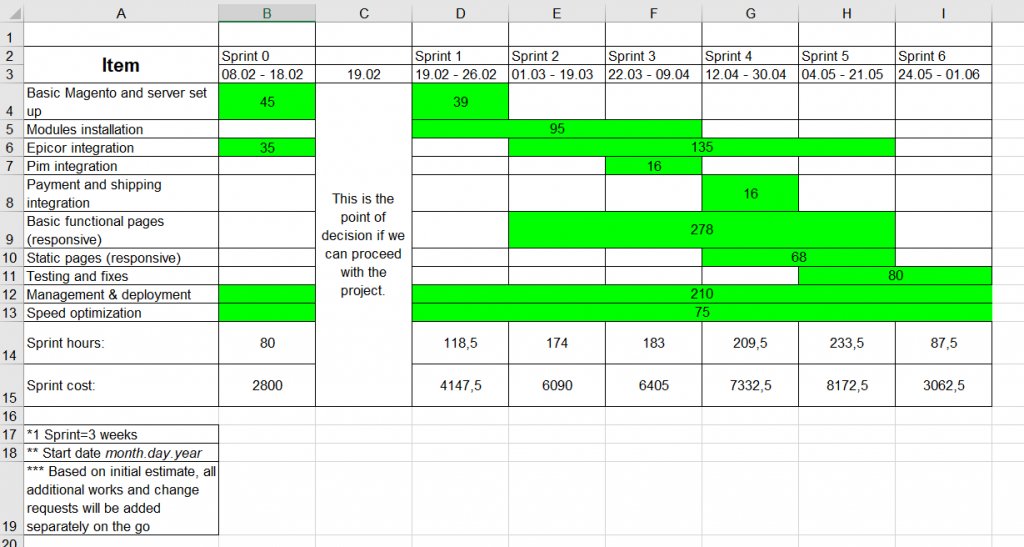

Example of a project timeline for one of Elogic’s clients. Gantt chart in action.

Most ecommerce website roadmaps are created in Excel or using project scheduling software (teamgantt is our personal favorite at Elogic). In fact, the latter have become so popular for their shareable and collaborative features, like real-time comments, task updates, and task assignment to a team member, among others.

Whatever approach to creating a timeline you choose, remember to stay specific and don’t be afraid to customize it as per your project requirements!

Step #5: Allocate the Budget

The last issue to resolve before your project goes into the implementation phase is the budget. At Elogic, we understand the value of your money and prepare two budget estimation documents based on a work breakdown structure for an ecommerce website and a timeline.

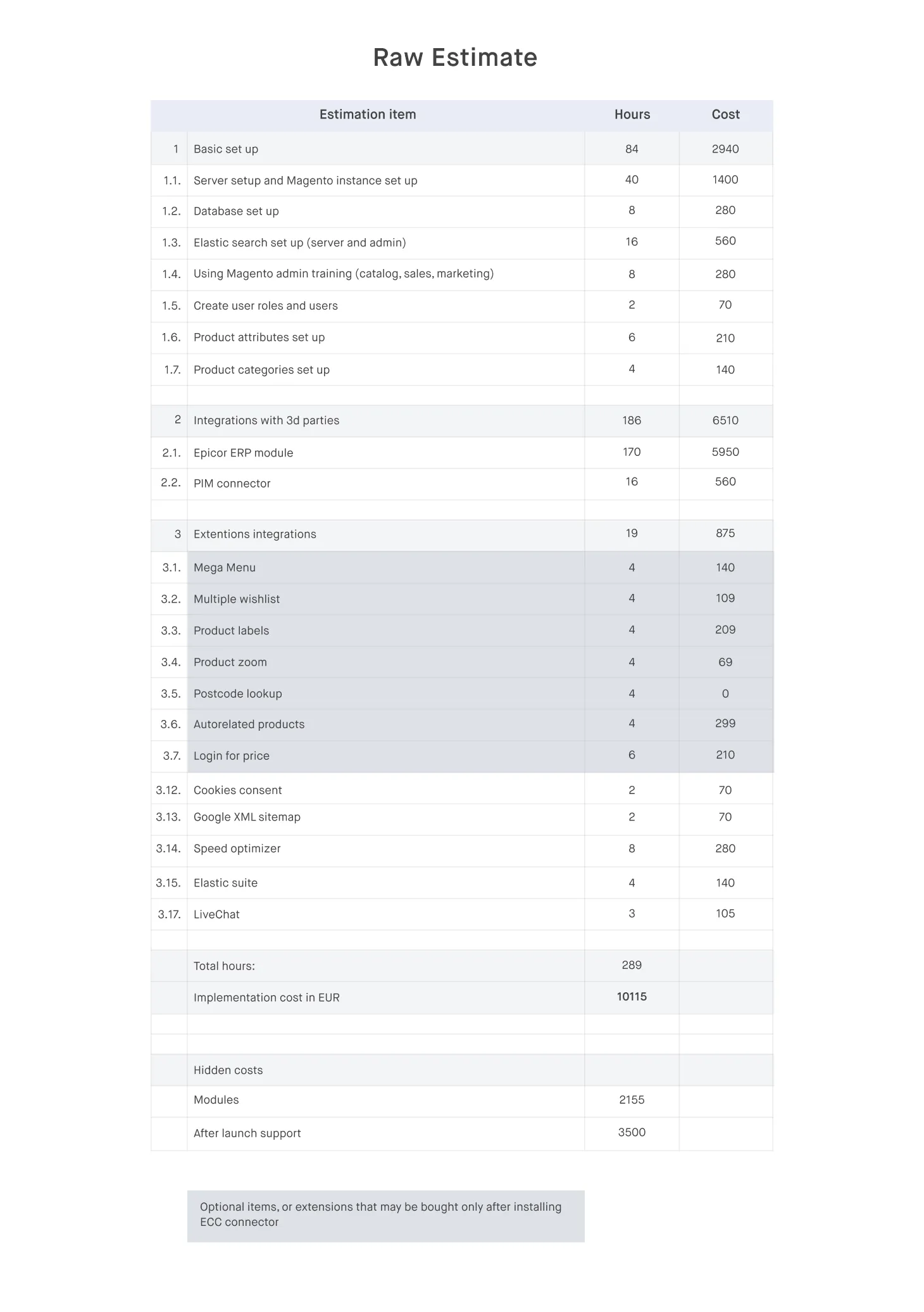

First, we specify the cost of each increment in WBS. All the tasks are written out in a spreadsheet along with the time allocated to complete them and the cost per task. In this raw estimate, we also indicate the hidden costs of module development and after-launch support. Non-essential tasks are also marked, so that our client can adjust the budget by adding or eliminating the requirements.

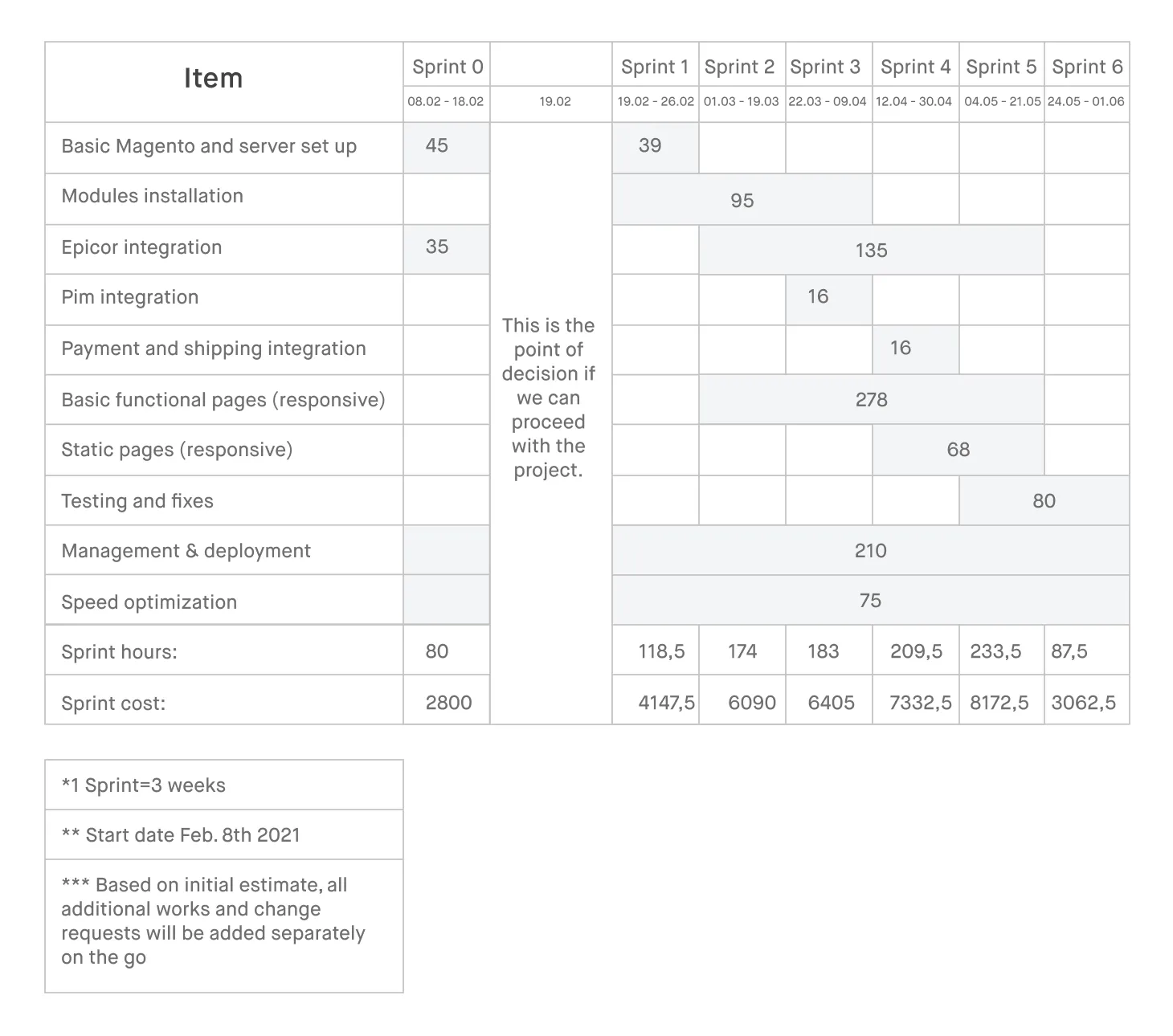

A spreadsheet breaking down the cost of the project based on WBS increments.
Example of a budget estimate based on WBS for our client.
*Costs are indicated for illustrative purposes only and can vary from the actual rate per hour.

Second, we prepare the calendar of payments as per the project timeline. As per Agile project implementation model, we organize all tasks into sprints at the end of which we report to the customer the completed milestones and results. As such, our client pays for what they receive within a set period of time.

A spreadsheet breaking down the costs of the project based on its timeline.
Example of a budget estimate based on a project timeline for our client.
*Costs are indicated for illustrative purposes only and do not offer precise estimates of a project.

Creating two types of estimate documents will allow a client to get a clear picture of the costs involved in project implementation as well as twist and tweak the tasks and timeframes to adjust the budget.

A Bonus Step: Deliver a Full PMI Project Plan [Elogic Clients Only]

Good news for those who choose Elogic! Upon our clients’ request, we form a full project plan following PMI best practices.

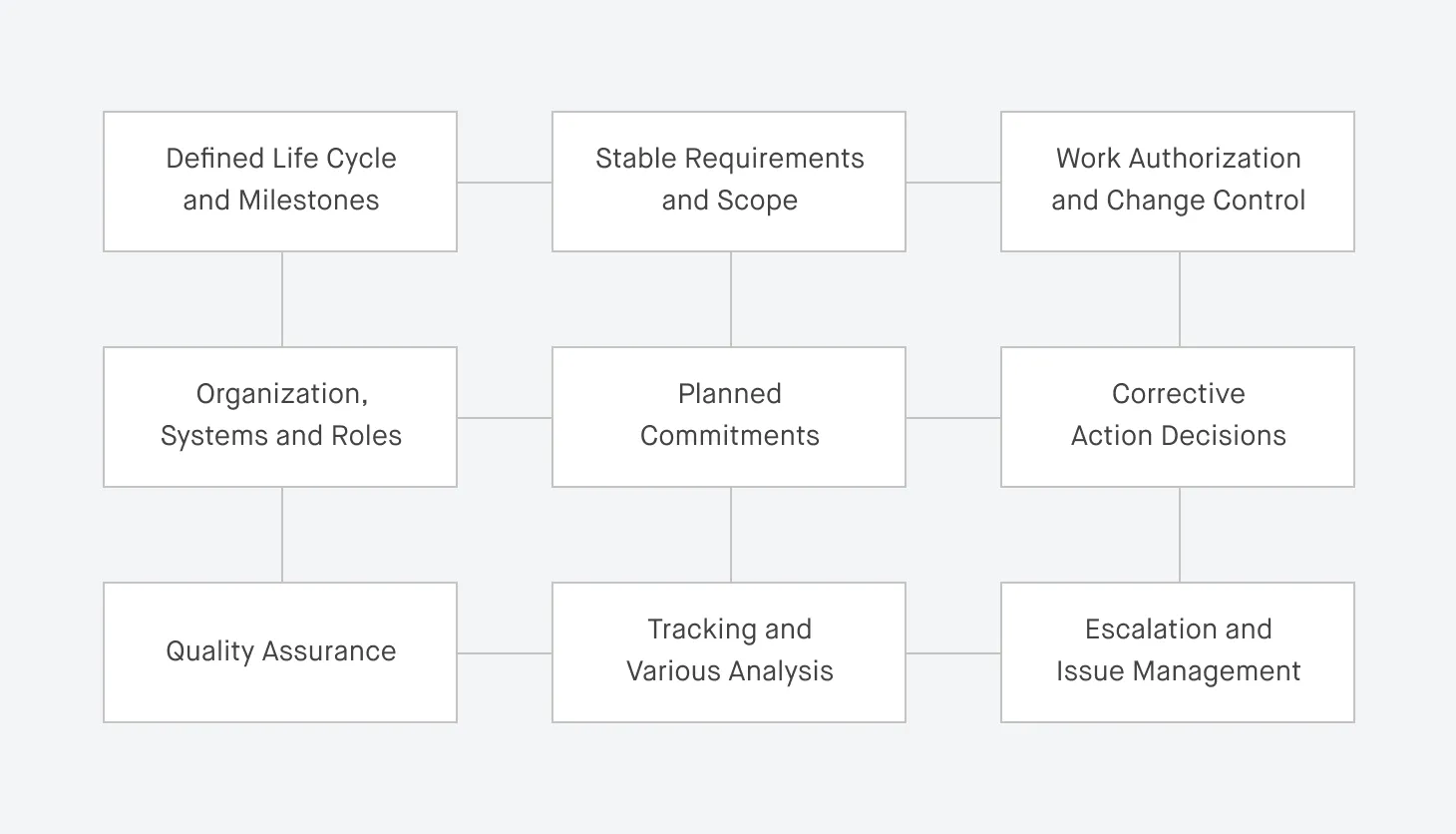

A diagram outlining nine best practices of project management.
PMI project planning best practices. Source: PMI.

Here are the practices we follow to ensure the project planning phase ends in a tip-top manner:

  1. Map out project life cycle and key milestones as well as communicate our way of work to the project stakeholders (consider this guide a demo version of how Elogic approaches project-planning in real life!).
  2. Discuss customers requirements and set a project scope to make sure that we stay on the same page with our client.
  3. Define organization, systems, and the roles and responsibilities for a project manager, functional managers, and team members.
  4. Conduct quality assurance checks, observe all results achieved during the phase, and look for ways to improve.
  5. Plan commitments, including the project at large, schedules, human resources, and budget.
  6. Track and analyze variances to avoid timeline slips and unresolved issues as well as measure project performance.
  7. Take corrective measures to address the detected variances and put the project back on track.
  8. Exercise an effective escalation procedure to ensure problems are resolved before they can affect the project progress.
  9. Put in place a formal process to change management.

By the end of the project planning phase, our client receives a full, detailed ecommerce website development project plan specifying what, when, and how our work will be delivered.

Let us take care of the cogs and clogs of your project and plan it for you!

Collaborate with Elogic for your Magento store development ambitious plans.

Develop your e-store now

How useful was this post?

Click on a star to rate it!

Average rating 4 / 5. Vote count: 18

No votes so far! Be the first to rate this post.

Davis
Get in Touch
Looking for a partner to grow your business? We are the right company to bring your webstore to success.
Table of contents
SHARE
Tell your friends about this article.
